(Image courtesy of Atlasco Constructional Engineers Ltd.)
Whilst concerns for health and safety are as important in the fabrication works and steel mill as they are on site, it is at the erection stage where the most visible aspects of unsafe practice might become apparent. It is also on site that design decisions and restrictions from other contractors can affect the steelwork contractor’s ability to perform safely. Hence, this article focuses on site safety during steel erection.
Steel the safe solution
As the designer your decisions can affect the health and safety of workers and others who will construct, maintain, repair, clean, refurbish and eventually demolish or remove the building or structure, as well as those who will use it as a completed workplace.
Taking risks arising from the design into account can positively affect the project and make it easier for these risks to be managed by contractors and those who will maintain or use the structure. The design forms an important part of delivering a project safely and without
risks to health.
Pre-engineered
(Image courtesy of Parker Steel)
Pre-planned
From the very beginning, specialist designers work with the construction team to ensure that the steel frame design can be manufactured and erected safely. Steel erection procedures can be planned in detail using 3D models and, for the most complex structures, trial assemblies can be staged to establish the best method of safe erection on site. Steelwork is standardised in a way that leads to repetition of site tasks and hence greater certainty of safe practice. Steel can be delivered to site as and when it is required, reducing the need for potentially hazardous on site storage.
Erected by specialists
Steelwork contractors are highly skilled specialists, trained in a single discipline. They must hold industry recognised qualifications in the design, fabrication and erection of steel-framed structures. That means the steel elements are quickly and accurately assembled on site following proven, reliable and safe techniques. Steelwork provides a framed solution that can be self-stable with immediate availability of the full strength of the material, enabling stairs to be fitted and providing safe access to the structure for other trades straight away. Steel decking for composite slabs also provides a safe platform after installation, as well as protection to lower storeys.
Future-proof
Steelwork is easily modified if necessary during maintenance or refurbishment, and is readily demountable should demolition be necessary at end of life.
Default solutions

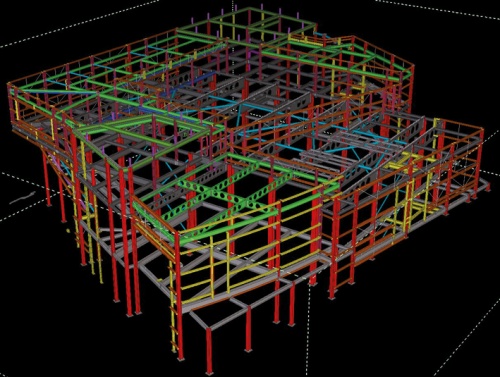

The basic concepts behind steelwork erection are easily understood in terms of default solutions.
(Image courtesy of Severfield (Design & Build) Ltd.)
- Start by erecting a braced bay to provide stability
- Use a mobile telescopic crane that can traverse the site
- Gain access to working positions using mobile elevating work platforms – the MEWP or ‘cherry picker’
For multi-storey construction:
- Use a stair core to provide stability
- Lift and place steelwork with the tower crane
- Gain access from metal decking or precast planks already placed on the floor below
(Image courtesy of Severfield plc.)
- Ensure the steel frame is aligned and stable to receive metal decking or precast planks
- Integrate the sequence of installation with the progress of steelwork erection
- Provide nets and edge barriers for general protection
Guidance from BCSA on the installation of metal decking is available in the Metal Decking Good Practice Guide:
- BCSA MDG 01 - Loading and Positioning of Packs
- BCSA MDG 02 - System Edge Protection Installation
- BCSA MDG 03 - Propping Guide
- BCSA MDG 04 - Concrete Pouring
The designer has obligations concerning the three safety objectives of stability, cranage and access that underpin these default solutions:
Stability
(Image courtesy of Severfield (UK) Ltd.)
Cranage
(Image courtesy of Severfield plc.)
Access
(Image courtesy of Billington Structures Ltd.)
Hazard, risk and competence
(Image courtesy of Mabey Bridge Ltd.)
The hazards arise from three of steel construction’s inherent characteristics:
- Large, heavy components must be lifted and placed into position.
- The structure can be unstable in the part-erected condition.
- Working at height.
However, the above hazards apply to other structural framing materials as well, and arguably steel is the safest solution in this regard.
To ensure that these hazards are safely dealt with, the risk assessment at design stage should conclude that a competent steelwork contractor must be chosen. To assist the choice, the BCSA provides a matrix of steelwork contractors who are competent to undertake contracts for both building and bridgeworks. This is more than just a list of companies as each applicant company must qualify by being assessed by specialist assessors who check the company’s financial resources, technical resources, health and safety criteria and track record. The result is two criteria:
- Categorisation of the company in terms of the work it can execute technically
- Classification of the company in terms of the maximum size of contract it should handle
The assessments provide clients with an easy way to pre-qualify steelwork contractors for buildings and bridges before contracts are tendered. This ensures that the successful steelwork contractor has the special skills to suit the project and helps the client to fulfil the regulatory duty only to use competent contractors to meet the requirements of both the Construction (Design and Management) Regulations and Building safety Regulations.
The categories of work are general and the precise scope of work demanded by each project will differ. Thus, the first priority for competent contractors is to ensure that the scope of work can be safely undertaken with the resources of know-how, manpower, equipment and finance at their disposal. For this purpose two checklists of competences are available:
- Normal scope of competence for activities that steelwork contractors should be competent to undertake with their own personnel
- Special scope of competence for activities that steelwork contractors should be able to manage using specialist subcontractors as necessary
Having checked at tender stage what a project demands, steelwork contractors should warn their clients if they are unable to undertake any of the normal activities, and their clients should check beforehand whether a steelwork contractor is willing to undertake any of the special activities.
Steelwork contractors, listed on the Register of Qualified Steelwork Contractors for Buildings (RQSC), can be selected according to the required project Class and Category on https://bcsa.org.uk/member-directories/.
Buildings
Applicants may be registered in one or more Buildings category to undertake the fabrication and the responsibility for any design and erection of:
- C - Heavy industrial platework for plant structures, bunkers, hoppers, silos etc
- D - High rise buildings (offices etc. over 15 storeys)
- E - Large span portals (over 30m)
- F - Medium/small span portals (up to 30m) and low rise buildings (up to 4 storeys)
- G - Medium rise buildings (from 5 to 15 storeys)
- H - Large span trusswork (over 20m)
- J - Tubular steelwork where tubular construction forms a major part of the structure
- K - Towers and masts
- L - Architectural steelwork for staircases, balconies, canopies etc.
- M - Frames for machinery, supports for plant and conveyors
- N - Large grandstands and stadia (over 5000 persons)
- Q - Specialist fabrication services (e.g. bending, cellular/castellated beams, plate girders)
- R - Refurbishment
- S - Lighter fabrications including fire escapes, ladders and catwalks.
Bridgeworks
A Register operates to cover bridgeworks. National Highways includes in its Specification for Highway Works[1] a requirement that only firms listed on the Register of Qualified Steelwork Contractors for Bridgeworks (RQSC) for the type and value of work to be undertaken will be employed for the fabrication and erection of bridgeworks.
Applicants may be registered in one or more sub-category to undertake the fabrication and the responsibility for any design and erection of:
- PG - Bridges made principally from plate girders
- TW - Bridges made principally from trusswork
- BA - Bridges with stiffened complex platework (e.g. in decks, box girders or arch boxes)
- CM - Cable-supported bridges (e.g. cable-stayed or suspension) and other major structures (e.g. 100m span)
- MB - Moving bridges
- SRF - Site-based bridge refurbishment
- FRF - Factory-based bridge refurbishment
- FB - Footbridges
- CF - Complex footbridges
- SG - Sign gantries
- AS - Ancillary structures in steel associated with bridges, footbridges or sign gantries (e.g. grillages, purpose-made temporary works)
Method statement development
Design decisions are often made before the appointment of a competent steelwork contractor that affect what erection methods can or must be used. These may emerge in the development of the construction phase plan or in the steelwork design process itself that depends on an assumed outline method of erection.
Site conditions
Items to be considered in defining the site conditions suitable for safe erection:
- Access to the site and within the site.
- Limitations on dimensions or weights of components that can be delivered onto the site.
- Soil conditions affecting the safe operation of plant.
- Provision and maintenance of hard standing for cranes and access equipment.
- Details of underground services, overhead cables or site obstructions.
- Special environmental and climatic conditions on and around the site.
- Particulars of adjacent structures affecting or affected by the works.
- Possible settlement of supports to the structure during erection.
- Availability of site services and prearranged procedures for cooperating with other contractors.
- Value of construction and storage loads allowed on the steelwork.
- Concrete placement during composite construction.
Design-basis method of erection

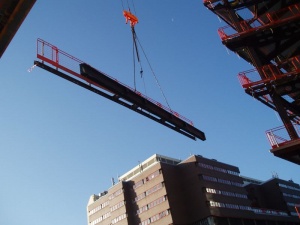

(Image courtesy of Easi-edge Ltd.)
- The position and types of site joints.
- The maximum piece size, weight and location.
- The sequence of erection.
- The stability concept for the part-erected structure including any requirements for temporary bracing or propping.
- Propping or other actions necessary to facilitate subsequent concreting of composite structures.
- Conditions for removal of temporary bracing or propping, or any subsequent requirement for destressing of permanent bracing.
- Features which would create a hazard during construction.
- Timing and method of grouting foundation connections.
- Camber and presets required including values to be checked at fabrication stage.
- Use of profiled steel sheeting to ensure stability.
- Use of profiled steel sheeting to provide lateral restraint.
- Possible method of providing safe working positions.
Construction phase plan
The principal safety objectives when erecting structural steelwork are:
- Safe access and working positions
- Safe lifting and placing of steel components
- Stability and structural adequacy of the part-erected structure
The most serious hazards during erection are related to falls from height, either from working positions or while gaining access to them. Other serious hazards are related to structural instability or failure during erection and while transporting, handling and lifting heavy components. The steelwork contractor's health and safety management system addresses the particular hazards and risks in steel construction as well as the normal range of issues in working on construction sites. The planning for health and safety is systemic to all the preparation for erection through risk assessment, devising safe systems of work and working up the erection method statement.
Typically, the full erection method statement will tackle:
- Experience from any trial erection undertaken.
- The restraints necessary to ensure stability prior to welding and to prevent local movement of the joint.
- The lifting devices necessary.
- The necessity to mark weights and/or centres of gravity on large or irregularly shaped pieces.
- The relationship between the weights to be lifted and the radius of operation where cranes are to be used.
- The identification of sway forces, particularly those due to the forecast wind conditions on site during erection, and the exact method of maintaining adequate sway resistance.
- Exact methods of coping with any identified safety hazards.
- Exact methods of providing safe access to positions of work and safe working positions
Stability
Designers must chiefly be concerned with ensuring stability as only they have full knowledge of the concepts upon which the design is based. Other key issues to consider are craneage and access. The concern is for stability during all stages of erection, and some issues for the designer to consider are as follows:
Final condition
- Will stability be by means of permanent steel bracing or sway frames, or will it depend on other construction elements such as concrete shear walls?
- Where will the permanent bracing be located?
- Will metal decking etc be used as diaphragms?
- How are load paths between components engineered?
Part-erected condition
(Image courtesy of Metsec Plc.)
- How will potential frame instability be overcome?
- How will the construction sequence dictate when load paths can be established?
- What construction loads will be permitted?
Individual members
- Are any members susceptible to instability when being lifted and placed?
- How could the need for lateral restraint be engineered?
- What restrictions might there be on rigging arrangements during lifting (e.g. for attachment of guys to members)?
Temporary works

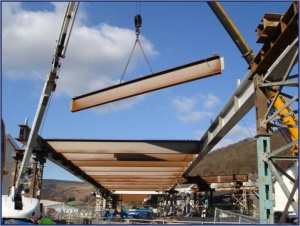

(Image courtesy of Mabey Bridge Ltd.)
- Does the scheme necessitate any bracing or propping?
- What forces and moments will develop in the temporary members?
- How will forces in tension members be developed?
- How will members be secured during site welding?
- Are there restrictions on how the temporary members might be connected?
Steelwork contractors are responsible for designing the actual temporary works to be used as they must match their chosen erection methods, but they need a clear brief specified by the steelwork designer.
Connections
Often the steelwork contractor will undertake the design of connections, and there can be an interaction between the selection of connection types and the need for temporary bracing or the sequence of erection. For instance a fin plate would be less robust in the part erected condition than a welded full-depth end plate. Similarly the choice of a column splice location could influence whether the column required stabilising by temporary guys when first erected. This in turn could depend on the design of the foundation itself and the column base plate connection.

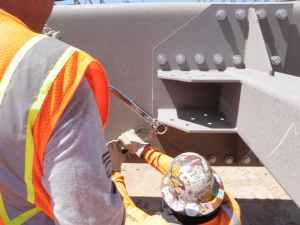

(Image courtesy of Lindapter)
The corollary of the default assumption noted previously, is that any special connection types should be given particular attention in terms of their implications for safe erection. For example, pin connections can give rise to a mechanism in the part-erected condition. This would need to be noted as a feature which would create a hazard during construction by whoever made the decision to select that connection type.
Site arrangements
Communication between the steelwork contractor and main contractor is of fundamental importance to the efficient and safe erection of constructional steelwork. Key issues are:
- Compliance with the Building Safety Regulations
- The provision of proper site conditions
- Segregation of contractors
- Cooperation between sub-contractors
Safe site handover certificate
- Facilitate the safe erection of steelwork, with the risks arising from poor site conditions removed, avoided or reduced,
- Provide details of the 'construction site fire safety plan'
- Provide a mutual basis for improved productivity, efficient working and reduced delay and, hence, reduced overall total cost,
- Establish criteria for safe site conditions as an inherent part of the steelwork tender offer, and as a mutually agreed basis for the commencement of delivery to site and of steelwork erection,
- Provide consistency of approach to safe site conditions,
- Assist Clients, Principal Designers, Principal Contractors and Steelwork Contractors alike to meet their respective responsibilities under health and safety regulations such as the Construction (Design and Management) Regulations[2]
A bridge version of the BCSA ‘Safe site handover certificate’ is also available.
BCSA has also developed sample ‘Handover Certificates’ to formally confirm that the steelwork has been checked for level and alignment etc. and is ready for the installation of the metal decking, and then subsequently the next phase of the construction work.
Segregation of contractors
For a specialist trade such as steel construction, the preferred solution is the operation of exclusion zones that are wholly within the steelwork contractor’s control. If this is not reasonably practicable, then the site arrangements must be agreed with full coordination of the access controls.
Cooperation between sub-contractors
The communication between the steelwork contractor and main contractor should also tackle the arrangements for cooperation between contractors, e.g. fixings for netting and edge protection.
Regulations
There are two key UK Regulations that impact steelwork contractors.
The regulatory landscape for construction in the UK has significantly evolved, particularly with the implementation of the Building Safety Act (BSA) 2022 alongside the established CDM (Construction Design & Management) 2015 regulations. Together, these frameworks place a heightened emphasis on client accountability, duty holder competence, and lifecycle safety. But what does this mean in practice, especially for specialist areas like structural steelwork fabrication?
Construction Design & Management (CDM) 2015
Clients play a central role in ensuring construction projects are compliant and safe from concept through to completion. Under CDM 2015, the client holds non-transferable legal duties, including:
- Allocating sufficient time and resources
- Developing a clear client brief
- Making formal appointments of Principal Designer (PD) and Principal Contractor (PC) in writing •
- Ensuring the provision of accurate pre-construction information (PCI)
- Reviewing the Construction Phase Plan (CPP)
- Maintaining welfare facilities in line with Schedule 2
- Ensuring F10 notifications are made and kept up to date
- Monitoring and verifying the arrangements throughout the project
- Retaining and distributing the Health and Safety File
This isn’t about clients doing all the work themselves but about making sure it gets done and documented. Clients can appoint competent advisors to assist them, but the legal responsibility always remains with them.
Steelwork Contractors must do the following:
- Co-operate with the principal contractor, co ordinator and others working on the project
- Tell the principal contractor about risks to others created by your work. This includes anything, for example from risk assessments and written systems of work, which might justify a review or update of the health and safety plan
- Comply with any reasonable directions from the principal contractor, and with any relevant rules in the health and safety plan
- Inform the principal contractor of any problems with the plan or risks identified during your work that have significant implications for the management of the project. This includes anything, for example from risk assessments and written systems of work, which might justify a review or update of the health and safety plan
- Tell the principal contractor about accidents and dangerous occurrences. You must provide information about RIDDOR incidents to principal contractors so that they can monitor compliance with health and safety law and, if necessary, review the arrangements for the management of health and safety
- Provide information for the Health and Safety File
- Where you are involved in design work, including temporary works, you also have duties as designers. (See BCSA Guidance for Designers.)
- Co-operate with the principal contractor in the development of the construction phase plan and its implementation. Where you identify shortcomings in the plan, you should inform the principal contractor.
The Building Safety Act (BSA) 2022
The Building Safety Act has created the Building Safety Regulator (BSR) that will enforce a more stringent regulatory regime and also oversee the safety and performance of all buildings. The Act imposes:
- Competence requirements on the Principal Designer and Principal Contractor, and any other persons, and
- Duties on those appointing them to ensure they meet the competence requirements.
Organisational competence
- For organisations, they will need to have the organisational capability – the ability of an organisation to carry out its functions properly.
- Having appropriate management systems, processes, policies and resources to carry out its functions under these Regulations and ensuring that individuals who carry out the work for them have the appropriate skills, knowledge, experience and behaviours for their roles.
Individual competence
- Under these regulations, individuals will need to have the skills, knowledge, experience and behaviours necessary for their role.
Duty Holder Role | CDM 2015 (Health & Safety) | Building Safety Act (Regulations & Compliance) |
Client | Manages H&S risks, appoints duty holders, provides the pre-construction information. | Ensures legal compliance, verifies competence, ensures gateway/building control submissions are made. |
Principal Designer (PD) | Plans, manages, and monitors H&S in the pre-construction phase. Eliminates or controls foreseeable risks. | Coordinates design work to ensure the design complies with building regulations. Assists in keeping the "Golden Thread" of information. |
Principal Contractor (PC) | Plans, manages, monitors, and coordinates construction work to ensure H&S. | Manages and monitors building work to ensure compliance with building regulations. |
Resources
- Allocation of Design Responsibilities in Constructional Steelwork, 2007, (Publication no. 45/07), BCSA
- Safe Site Handover Certificate and Checklist, 2022, BCSA
- Normal scope of competence, BCSA
- Special scope of competence, BCSA
- Guide to Steel Erection in Windy Conditions, 2005, (Publication no. 39/05), BCSA
- Code of Practice for Erection of Multi-Storey Buildings, 2006, (Publication no. 42/06), BCSA
- Guide to the Erection of Steel Bridges, 2005, (Publication no. 38/05), BCSA
- Guide to Work at Height during the Loading and Unloading of Steelwork, 2007, (Publication no. 43/07), BCSA
- Code of Practice for Metal Decking and Stud Welding, 2014, BCSA
- Guide to the Management of Site Lifting Operations, 2009, (Publication no. 47/09), BCSA
- Code of Practice for the Erection of Low Rise Buildings, 2004, (Publication no. 36/04), BCSA
- Health & Safety on Steel Construction Sites: Guide for Employees, 2009 (Publication no. 48/09), BCSA
- Steel Bridges: A practical approach to design for efficient fabrication and construction, 2010, (Publication no. 51/10), BCSA,
- Chapter 9 – Competence in Steel Construction
- Steel Buildings, 2003, (Publication no. 35/03), BCSA
- Chapter 20 - Health & Safety
- SCI P358 Joints in Steel Construction: Simple Joints to Eurocode 3, 2014
- Sample steelwork handover/acceptance certificates, 2017, BCSA:
- Metal Decking Good Practice Guide, 2016, BCSA:
